empty
Learn how to use the empty function in Notion formulas.
The
empty()
function returns true if its argument is empty, or has a value that equates to empty - including 0
and false
.1
empty(string)
2
empty(number)
3
empty(Boolean)
4
empty(date)
1
empty("") // Output: true
2
3
empty(0) // Output: true
4
5
empty(false) // Output: true
6
7
// Assume a row where the Name property is currently blank
8
empty(prop("Name")) // Output: true
1
// Assume a row where the Name property contains text
2
not empty(prop("Name")) // Output: true
3
4
// The same result can be accomplished with conditional operators
5
// (Assume the Name property contains text in this row)
6
empty(prop("Name")) ? false : true // Output: true

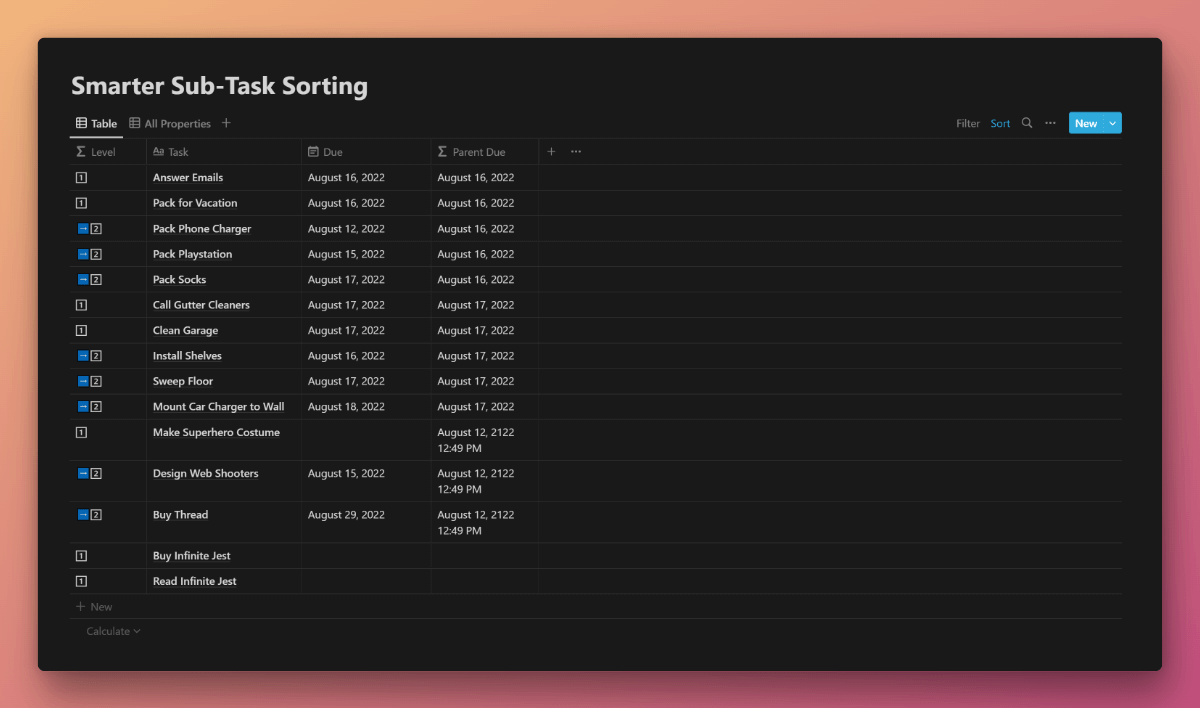

The example database below shows how you can sort sub-tasks by their parent task's due date. This pictured view is simplified for ease-of-use; view the database's All Properties tab to see every property at work.

1
// Compressed
2
if(not empty(prop("Parent Task")), prop("Parent Due Rollup"), if(empty(prop("Sub-Tasks")), prop("Due"), if(not empty(prop("Due")), prop("Due"), dateAdd(now(), 100, "years"))))
3
4
// Expanded
5
if(
6
not empty(
7
prop("Parent Task")
8
),
9
prop("Parent Due Rollup"),
10
if(
11
empty(
12
prop("Sub-Tasks")
13
),
14
prop("Due"),
15
if(
16
not empty(
17
prop("Due")
18
),
19
prop("Due"),
20
dateAdd(
21
now(),
22
100,
23
"years"
24
)
25
)
26
)
27
)
This formula uses both
empty()
and not empty()
in conjunction with multiple nested if statements in order to determine a Parent Due Date.The entire database view is then sorted by:
- 1.Parent Due Date
- 2.Parent Task Name
- 3.Due Date

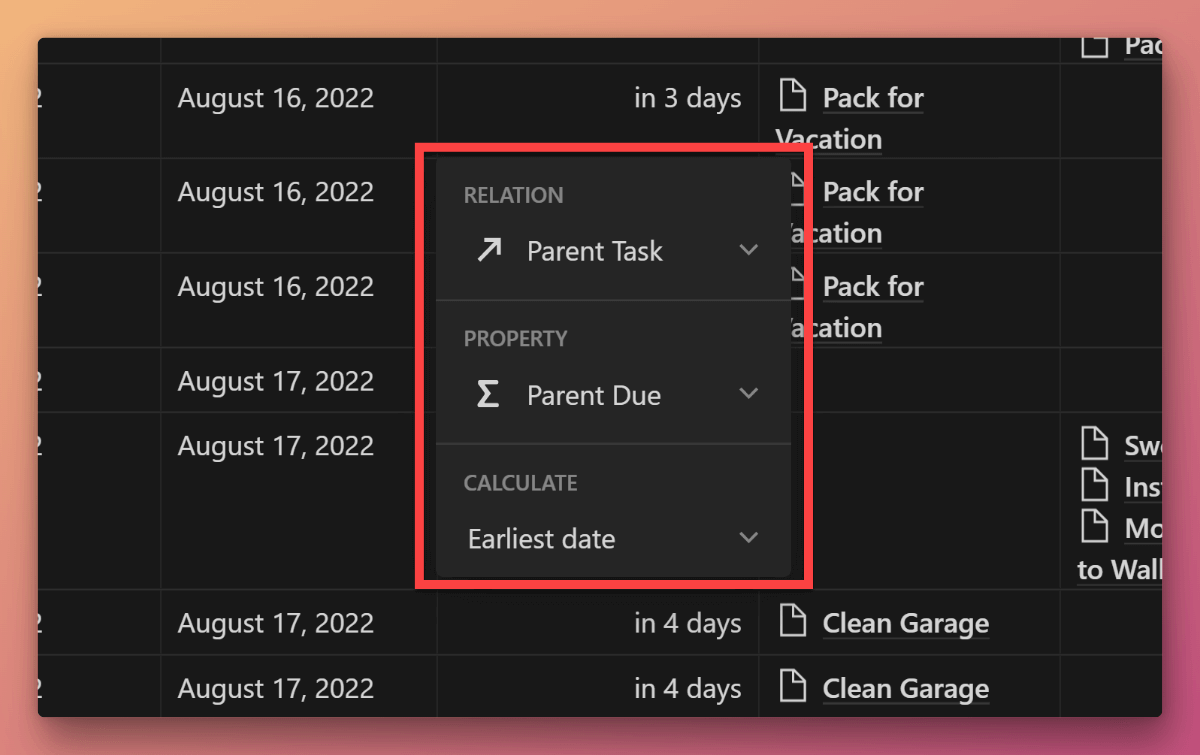

Notice that the formula also calls in a Parent Due Rollup property, which is actually configured to pull in the Parent Due Date content of the Parent Task:

That's right - this is a formula, which pulls in its own output (from other database rows)!
Let's work through what this formula is doing:
- 1.First, it checks if Parent Task is not empty. If so, we know we're dealing with a sub-task, so we output the value of Parent Due Rollup. Note that Parent Due Rollup's content is determined by the rest of the logic in this formula.
- 2.If Parent Task is empty, then we check if Sub-Tasks is empty as well. If so, we're dealing with a "lone" task - it's not a parent task nor a sub-task. In this case, we output its Due date value.
- 3.If Sub-Tasks is not empty, then we know we're dealing with a parent task. Next, we check if its Due property is not empty.
